What is a PERT chart?
A PERT chart is a network diagram that maps out a project's tasks, the order they have to happen in and how long each one is likely to take. PERT stands for Program Evaluation and Review Technique, and you'll also see the chart called a PERT diagram or PERT network diagram.
Each task is a node, and arrows show which tasks depend on others. Instead of one fixed estimate, every task gets three: optimistic, most likely and pessimistic. That's what makes PERT useful when you can't be sure how long the work will take.

PERT was developed by the US Navy in 1958 to simplify the planning of the complex Polaris missile submarine project. The research and production of new components for the submarine were distributed to various contractors. It wasn’t possible to calculate the exact time and effort required for the individual steps, which is why the contractors were asked to provide an estimate of the possible duration.
At the same time, the private sector developed the critical path method (CPM). Both methods map out the project timeline, but CPM uses a single fixed estimate for each task. PERT works with three estimates instead:

PERT is, therefore, a more differentiated approach than the critical path method.
The PERT model was also used in the organization of the 1968 Grenoble Winter Olympics. Although numerous similar management concepts have been devised and developed since then, PERT was the first technique of its kind – and it’s still popular today.
PERT chart example
Here's a simple PERT chart example for launching a product landing page. Each task has three time estimates in days, and the expected time comes from the PERT formula.
Task
Depends on
Optimistic (O)
Most likely (M)
Pessimistic (P)
Expected time
A. Write the copy
2
3
6
3.3 days
B. Design the page
3
4
8
4.5 days
C. Build the page
A, B
4
5
9
5.5 days
D. Set up analytics
1
1
3
1.3 days
E. Test and fix
C, D
1
2
4
2.2 days
F. Launch
E
1
1
1
1.0 day
The longest chain is B, C, E and F: 4.5 + 5.5 + 2.2 + 1.0 = 13.2 days. That's the critical path, so a delay to any of those four tasks pushes back the launch. Writing the copy (A) and setting up analytics (D) have slack: they can slip a little without moving the finish date.
Discover the PERT Chart Template by MindMeister Public Maps. Tailor this PERT chart template to your project and link out to it from your MeisterTask overview task.
Why use a PERT chart in project management?
As a project manager, a PERT chart helps you visually plan a project in a structured way and execute it methodically. Use a PERT chart to evaluate the schedule, the resources you need and the critical path of your project. Doing so will:
Improve your time management. A PERT chart highlights both the individual task duration and the overall project duration. It’s a great method to define the expected schedule in detail during the project planning phase.
Improve your resource management. With a PERT chart, you can easily see which tasks require which resources. This saves you and everyone involved in the project time, as everyone can easily access the information independently.
Improve your project overview. One of the key features of a PERT chart that sets it apart from other methods is its ability to determine the critical path of a project. The critical path method is important if you want to visualize the schedule of your project with all of its task dependencies and uncertainties.
When should you use a PERT chart?
As mentioned above, PERT was developed for planning extremely complex projects. In other words, projects in which you and your team must coordinate and work through many parallel and consecutive tasks.
If your project requires allocating multiple tasks to various team members, a PERT chart can help. This practical template provides a robust framework that can serve as a basis for further steps.
However, to implement the PERT model, you also need reliably observed data from the past or clear expert estimates of future expectations. If you do not have this data, the results will not be accurate or helpful.
If you’re dealing with a fairly straightforward project, introducing the PERT model will only cause confusion. Valuable time will be wasted on estimations, which are unnecessary due to the lack of detail in the project. Note that there are disadvantages to PERT charts, including:
Calculating PERT and creating a chart is time-consuming. Once you start subdividing all the necessary tasks, the number of tasks to manage can quickly become overwhelming.
You need to create a PERT chart before the launch of your project for the administrative effort to be worth it.
If the optimistic and pessimistic estimates deviate greatly from the probable value, you’ll end up with a distorted result, which can ultimately lead to bad decisions.
It’s difficult to give a concrete indication of the project duration, even with expert input.
Diagrams such as PERT charts help illustrate expectations, but not the project status.
Expectations are not necessarily met during the project, which can quickly make your PERT chart redundant.

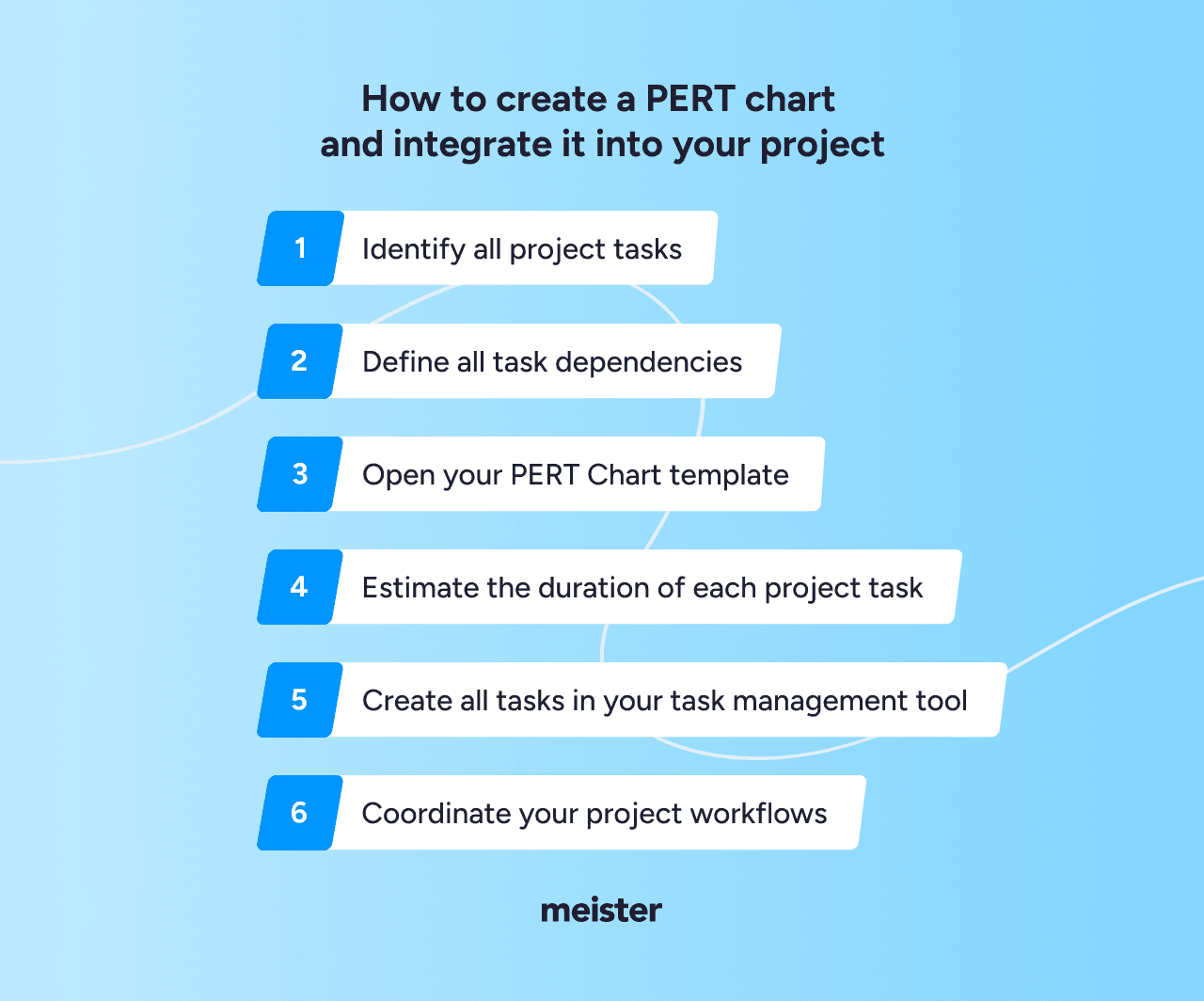

How to make a PERT chart in 6 steps
Follow these 6 steps in order to build your PERT chart and put it to work:

1. Identify all project tasks
To create a successful PERT chart, start by identifying and collecting all project information and tasks. Use either a mind map or a note in your task management tool.
Not using a digital task management tool? Find out why you should and how it benefits your team.
Whichever you choose, share it with your team and work on it collaboratively to quickly gather more insights. More eyes on it means less chance anything will be forgotten.
2. Define all task dependencies
You should now identify all tasks that rely on the completion of another task to be worked on.
Identifying all task dependencies will help you to:
Allocate tasks appropriately and follow up on them later.
Ensure the timely completion of tasks.
Make clear what needs to be communicated, when and to whom.
3. Open the PERT chart template
The quickest way to make a PERT chart is to open the MindMeister template (shown under "PERT chart example") and transfer the final tasks and dependencies, in a logical order, into your task management tool.
To make this easier, number the tasks and add the responsible person to your list before you transfer the information over.
4. Estimate the duration of each project task
Now plan your timeline by working out an expected time for each task with the PERT formula. The PERT formula section below explains how it works, with a worked example.
This calculation relies on previous experience and data. It helps you tell your team how long a task will realistically take, ideally right in your MeisterTask tasks.
5. Create all tasks in your task management tool
Create all the main or “parent tasks” for your project in your task management tool. Define the person responsible for the task, add all project participants as watchers, and link out to your project overview note and PERT diagram.
It’s likely your task requires contributions from multiple team members. To provide more clarity as to what needs to be done and when, break down your high-level tasks into subtasks. Assign them to the responsible person with the required due date. However, keep discussions in the parent task. That way your team uses it as the single source of truth for the project, so nobody misses an update.
6. Coordinate your project workflows
Now all that remains is to coordinate the delivery of the tasks until the project is complete. Keep communication in the parent task, where the linked PERT diagram is always one click away, so you and your team can track each task's progress and share updates. Switch to the timeline view to see how tasks connect and spot anything running late.
Subscribe to our blog
Get the latest articles in your inbox
You can find out more about how we handle personal data in our Privacy Policy.
PERT formula: how to calculate expected time

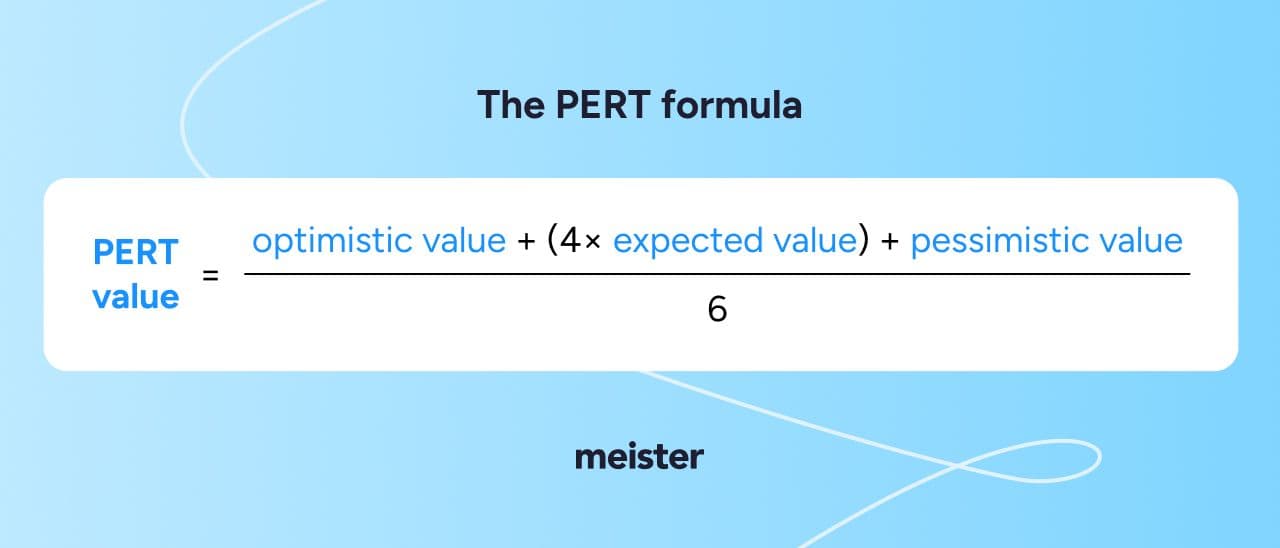

The PERT formula turns your three estimates into one expected time for each task:
Expected time = (O + 4M + P) ÷ 6
O is the optimistic time, if everything goes well. M is the most likely time. P is the pessimistic time, if things go wrong. This is also called three-point estimation.

The formula gives you a weighted average of the three estimates. The most likely estimate counts four times, so one extreme guess can't skew the result. The answer is the task's expected time, also called the PERT value.
PERT analysis goes one step further and measures how uncertain each estimate is. The standard deviation is (P - O) ÷ 6: the wider the gap between best and worst case, the riskier the task.
With PERT, you usually calculate back from a fixed end date rather than the other way around, as contractor deadlines often cannot be moved.
PERT formula example
Say a marketing team needs to turn its campaign data into a visual report.
The team knows from experience that under optimal conditions, when all the information is available, they require 300 minutes to do this. Under normal conditions, when only individual pieces of information need to be researched, it takes 450 minutes. Under unfavorable conditions, when missing documents have to be requested, 600 minutes. The planned values are calculated using the PERT formula as follows:
Expected time = (300 + (4 × 450) + 600) ÷ 6 = 2,700 ÷ 6 = 450 minutes, or 7.5 hours
PERT chart vs Gantt chart vs CPM
All three charts have a common purpose: to improve project planning. But there are a few key differences between them.

PERT chart vs Gantt chart
PERT and Gantt charts are often conflated, but there are important differences between them. Not only do they differ visually, but they also offer different functions to suit different needs.
PERT charts are flowcharts, Gantt charts are bar charts. The former are less structured in their appearance and the layout can be slightly different depending on the project.
Gantt charts score points for their organization, but PERT charts have value because they’re customizable. Gantt charts offer an organized structure while PERT charts allow for easy layout customization, which is better suited for presenting top-level project plans.
PERT charts are best used before the project begins. With their simple timeline-friendly layout, PERT charts are typically used as visual aids during a project kick-off. Project managers then like to use other methods, such as a work breakdown structure, a Gantt diagram or a Kanban board, to specifically assign project tasks and highlight dependencies.
Ultimately, Gantt charts are best suited for mapping project tasks throughout the project cycle, while PERT charts are best used for planning and scheduling in the initial project phase. The charts can be used separately or together to create a comprehensive project plan.
PERT chart vs CPM
Both charts, i.e. PERT and CPM charts, are models for project planning and management. They’re used to efficiently plan and organize task sequences for larger projects.
The main difference: PERT handles uncertainty with three time estimates per task, while CPM uses one fixed estimate and focuses on the critical path, the longest chain of dependent tasks, which sets the earliest possible finish date.
For optimal results, you can use CPM charts in parallel with PERT charts. By integrating both methods into your project management strategy, you can give your team a realistic deadline and provide the optimal workflow for your project.
So is PERT more accurate than CPM? When task times are uncertain, yes, because it accounts for the spread between best and worst cases. When you know your task times well, CPM is simpler and just as reliable.
Get productive with PERT
Ready to try it? Open the PERT chart template in MindMeister and adapt it to your project. Then move the tasks into MeisterTask, where Gantt-style timelines keep every deadline in sight.
FAQ: PERT chart
A PERT chart is used to plan projects where task times are uncertain. It shows which tasks depend on each other, estimates how long the whole project will take and highlights the critical path, the chain of tasks that sets the earliest finish date.
A PERT chart is a network diagram that shows task order and dependencies, and it's mostly used to plan before a project starts. A Gantt chart is a bar chart on a calendar timeline, used to schedule and track work while the project runs.
The PERT formula calculates a task's expected time from three estimates: (O + 4M + P) ÷ 6, where O is the optimistic time, M the most likely time and P the pessimistic time. The most likely estimate counts four times as much as the other two.
It depends on how well you know your task times. PERT handles uncertainty better because it uses three estimates per task. CPM uses one fixed estimate, so it's simpler and works well when task times are predictable.
You can draw one in Excel with shapes and connector arrows, with each task as a box showing its expected time. It's slow to update, though. A mind map template is quicker to edit, and you can then move the tasks into a project tool to track them.
